Project · Simi Valley guest house
Detached
ADU construction,
Simi Valley
Residential & ADUs
Overview
An 880 square foot detached guest house in Simi Valley, built from a cleared plot through to final inspection. It has two bedrooms, one bathroom, and an open cathedral ceiling running the length of the living space, which is what took the framing from about one week to three. The job began in January 2024 and passed final inspection at week fourteen.
- Location
- Simi Valley, Ventura County
- Client
- Private residential
- Size
- 880 sq ft
- Accommodation
- Two bedrooms, one bathroom
- Built
- January 2024, 14 weeks
- Status

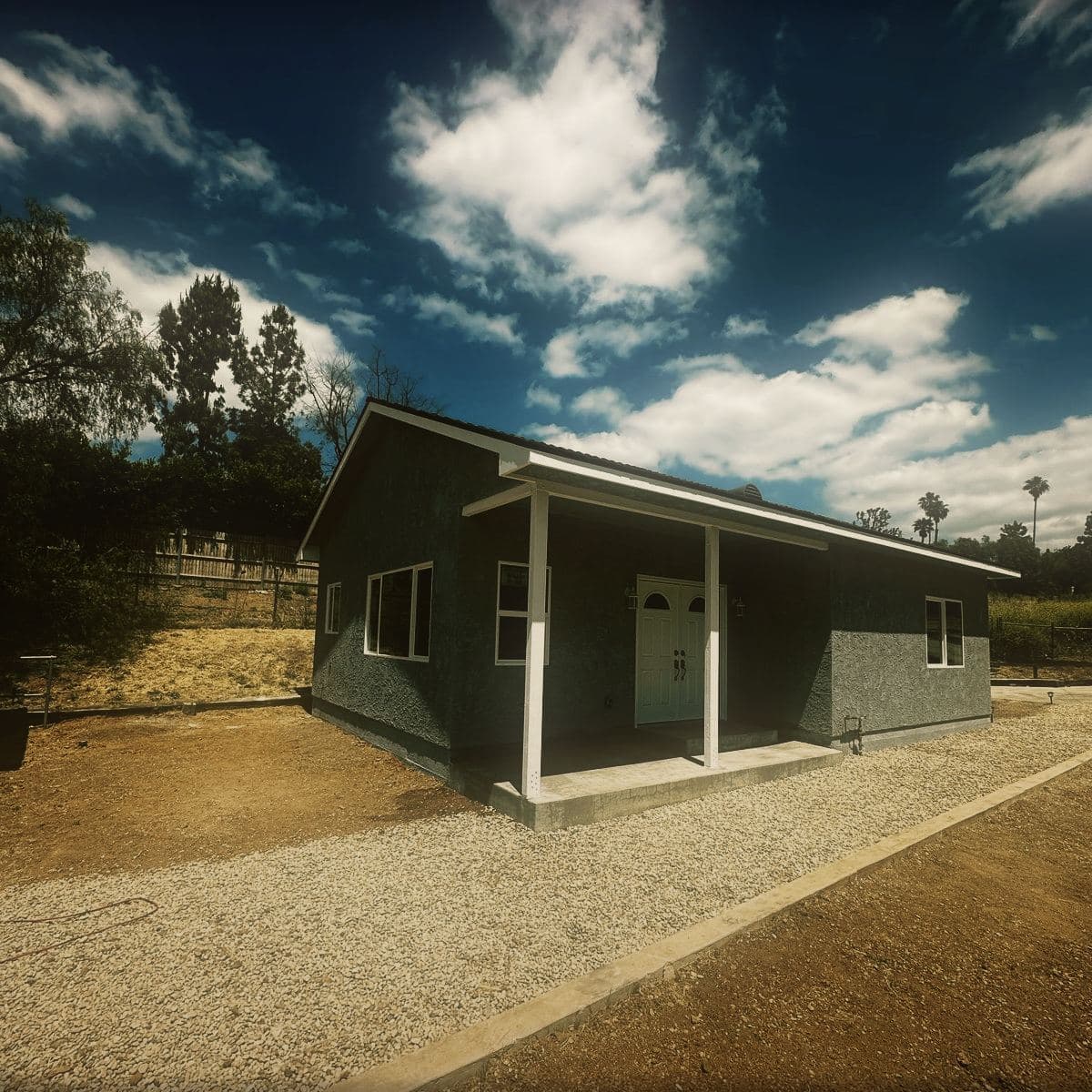

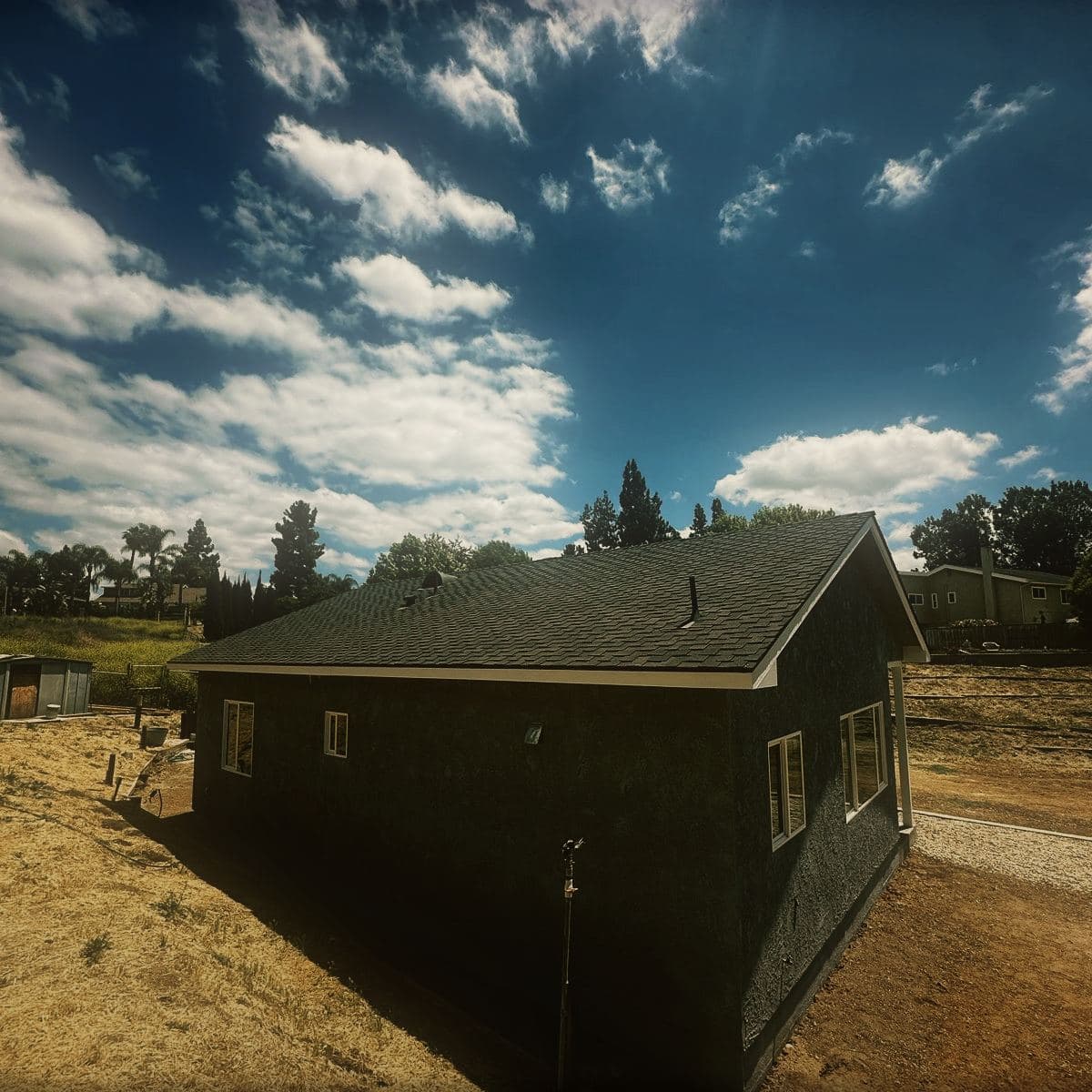

- Completed, passed final inspection
Scope of work
- Site clearance and grading to a level building pad
- Footings excavated, formed and reinforced
- Foundation and slab poured and finished
- Timber framing to an open cathedral ceiling
- Roof, windows and exterior finishes

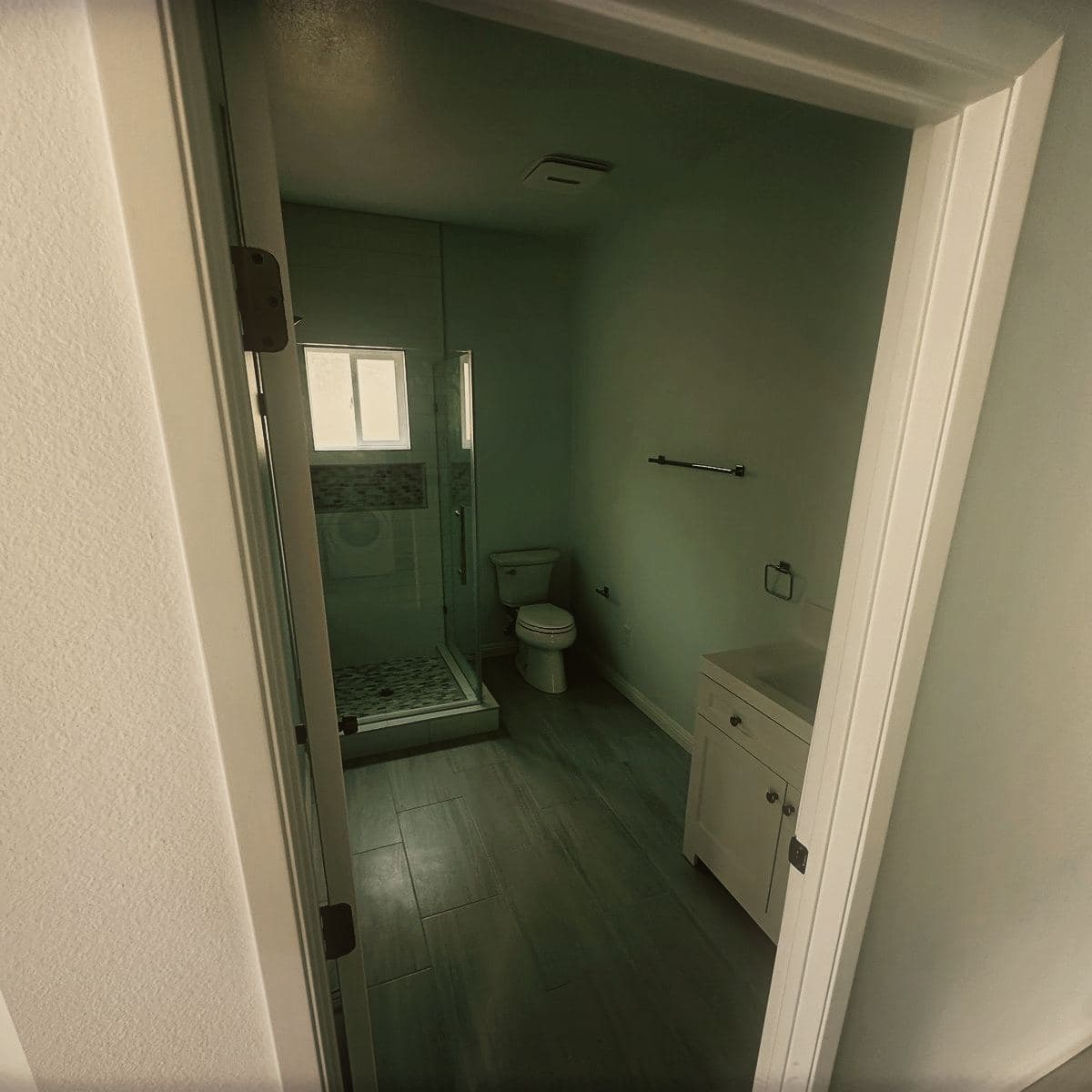

- Interior trades, kitchen and bathroom fit-out
- Through to final inspection
Site challenge and execution
An open cathedral ceiling instead of a flat one

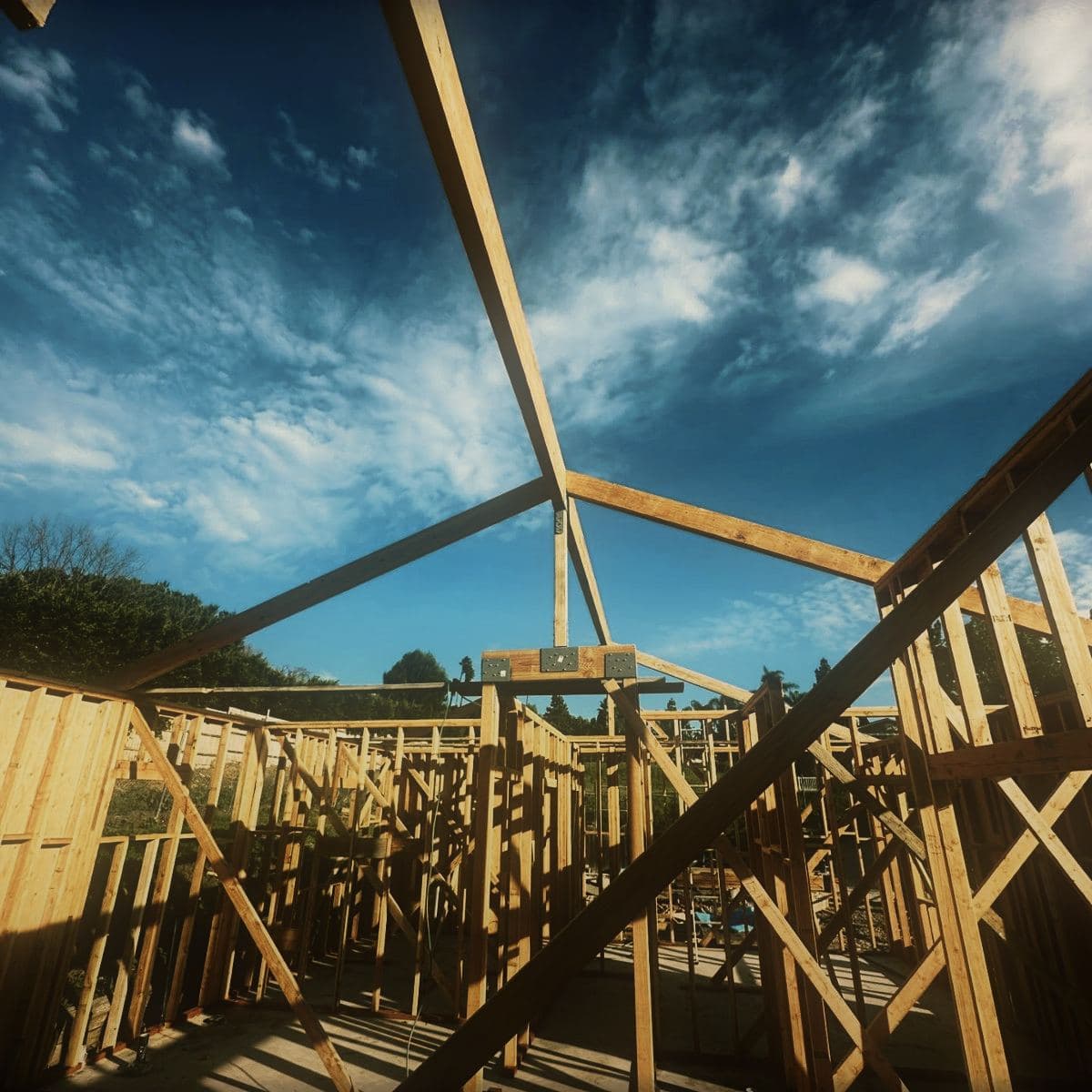

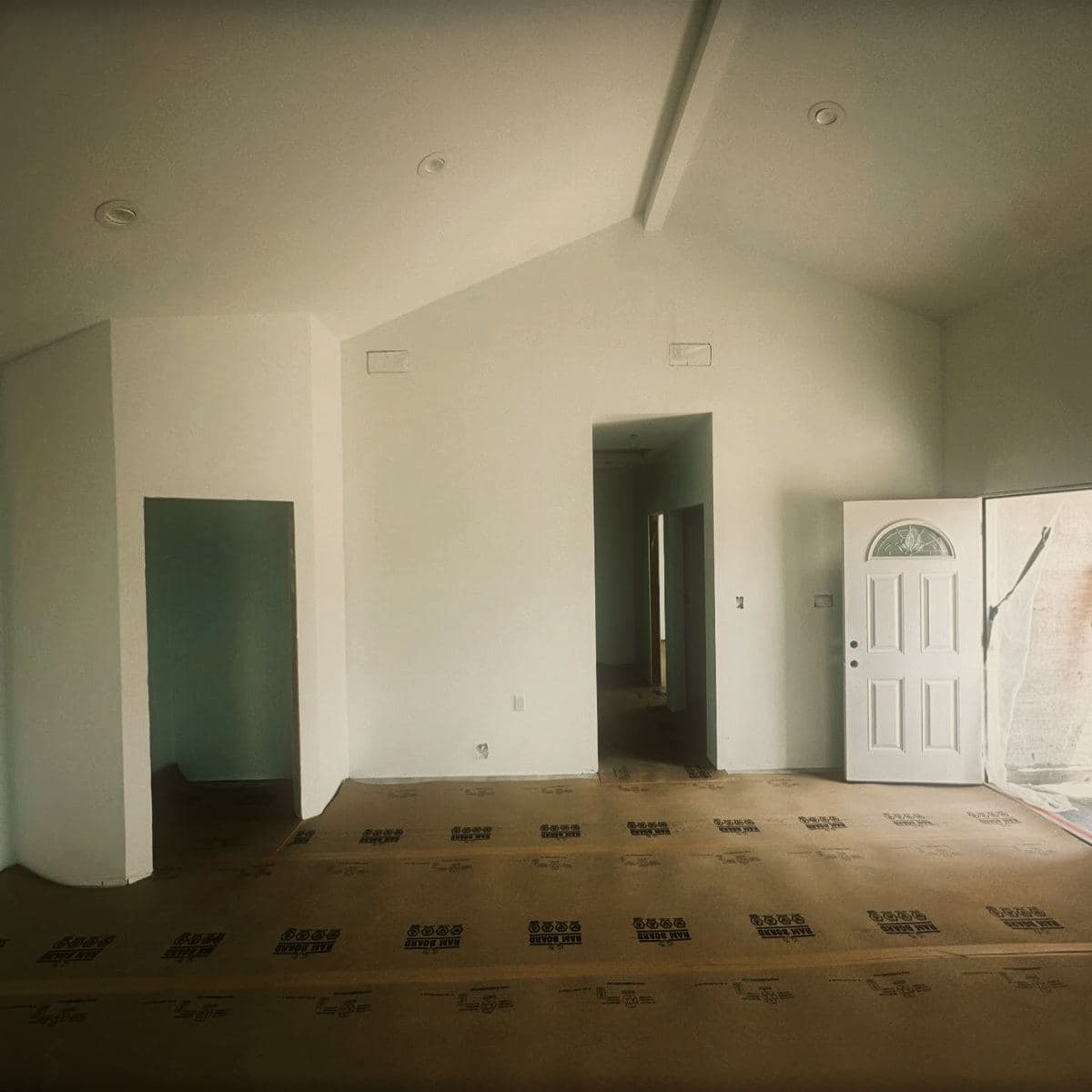

The owner asked for an open cathedral ceiling running the length of the living space rather than the flat eight-foot ceiling a guest house this size would normally have. That turns the roof from a surface into structure: it has to carry its loads without a ceiling tying the walls together, so the members, the connections and the bracing are all different.
It cost time rather than difficulty. Framing ran to three weeks against roughly one for a standard flat-ceilinged frame of the same footprint, and week six lost all but three days to rain.
How the job ran
Grading and footings

January 2024

The plot was cleared and graded to a level pad, and the footings were then dug, formed and reinforced around the footprint.
Foundation and slab

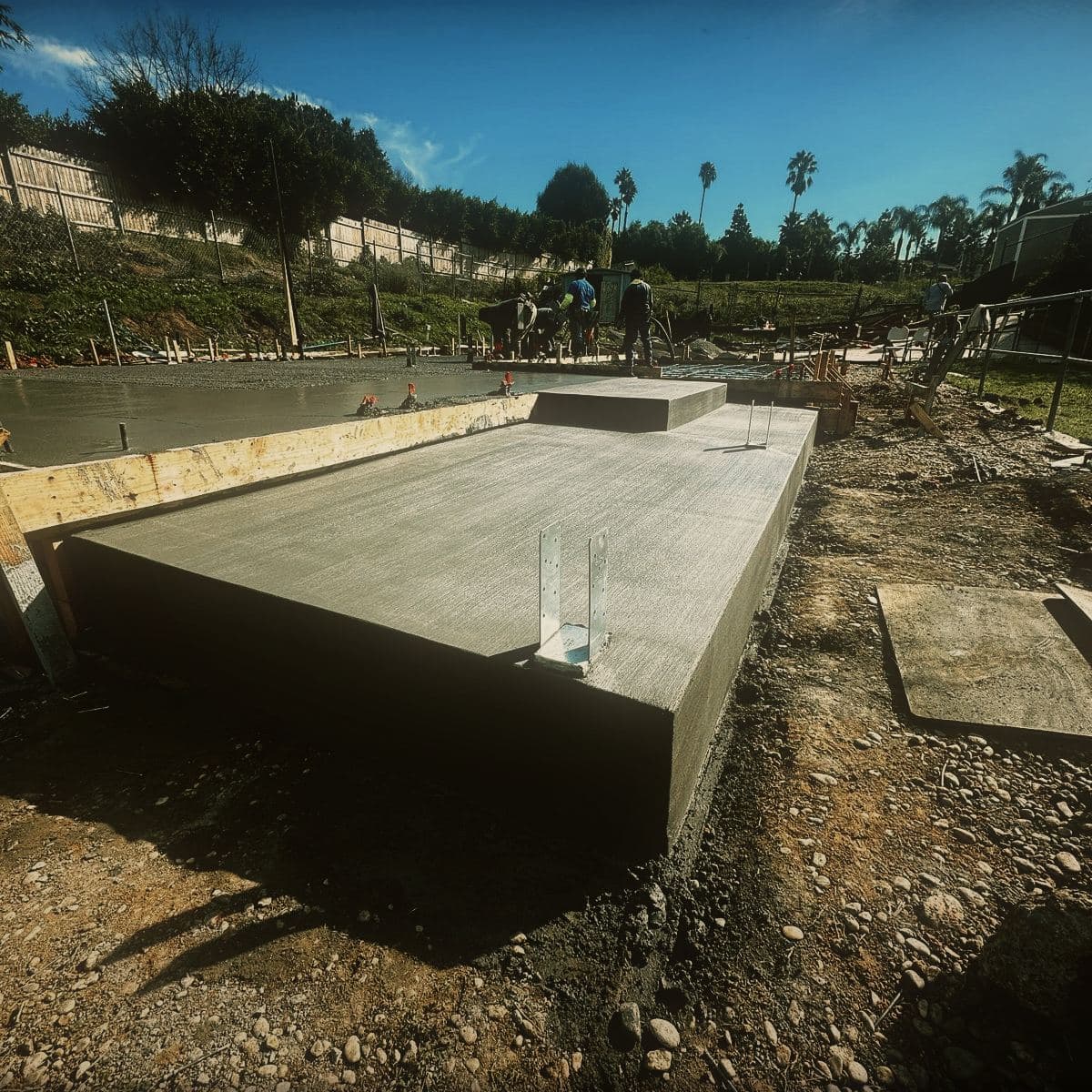

to end of January 2024

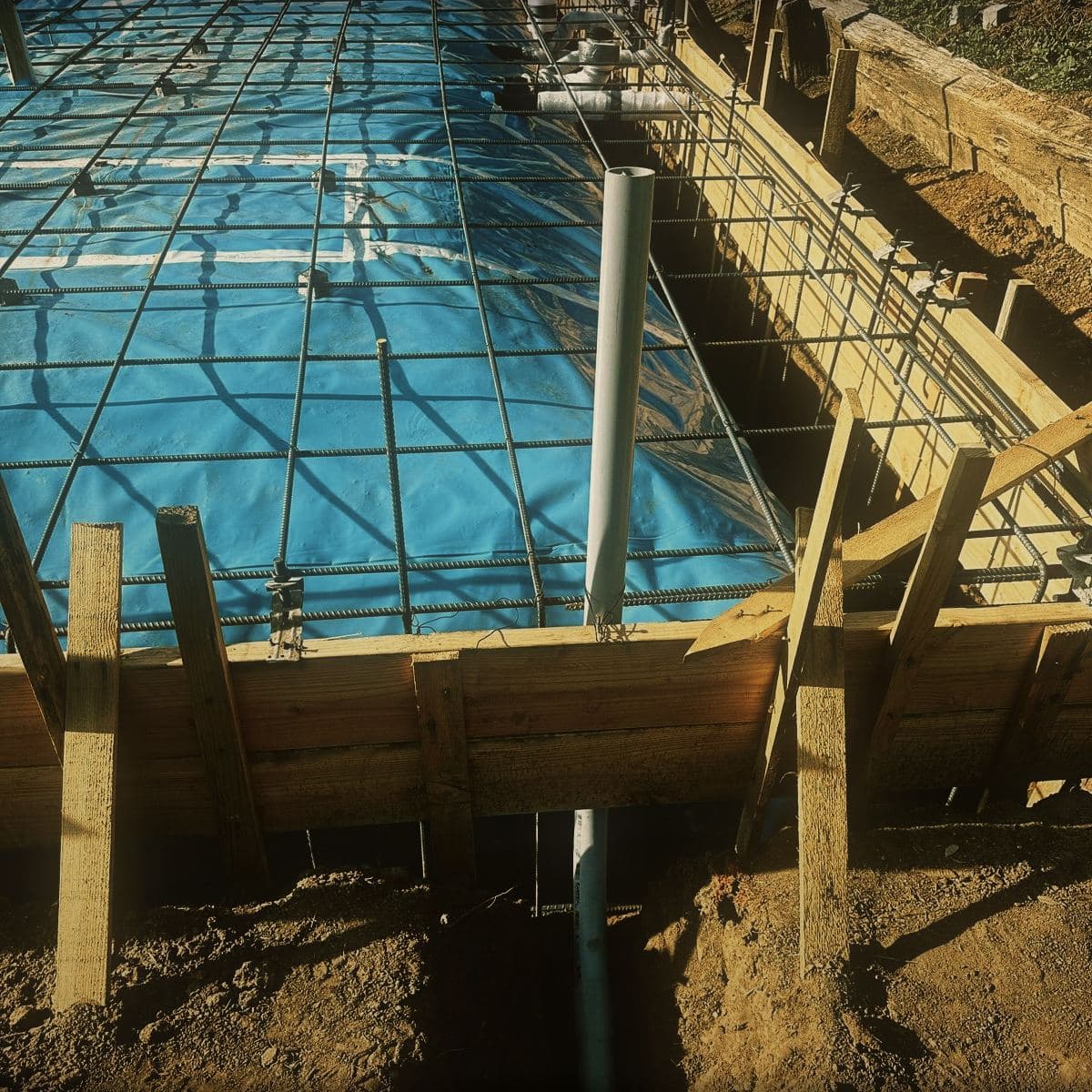

The foundation and slab were poured and finished, closing out the groundwork and giving the frame something to stand on.
Framing
weeks 5–8

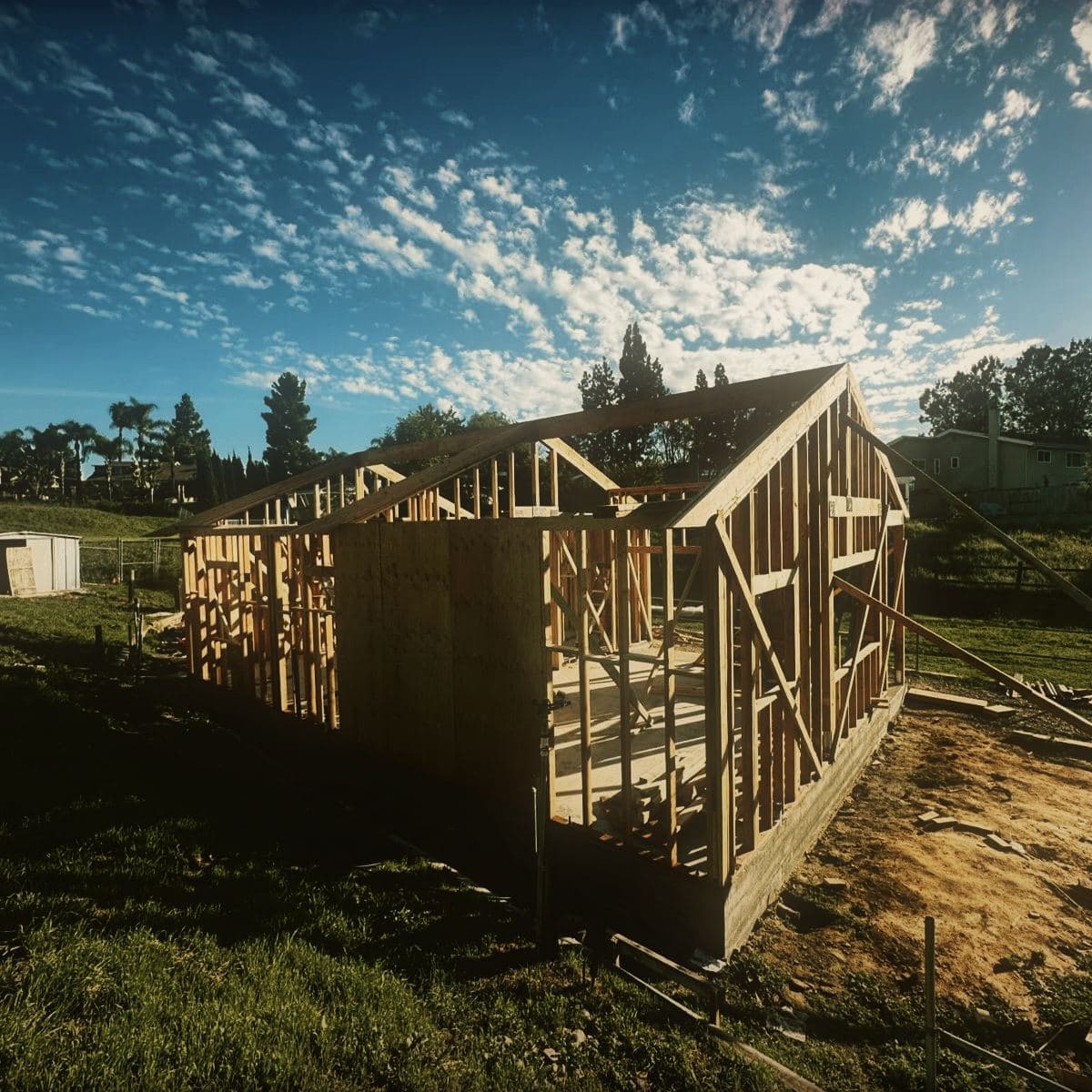

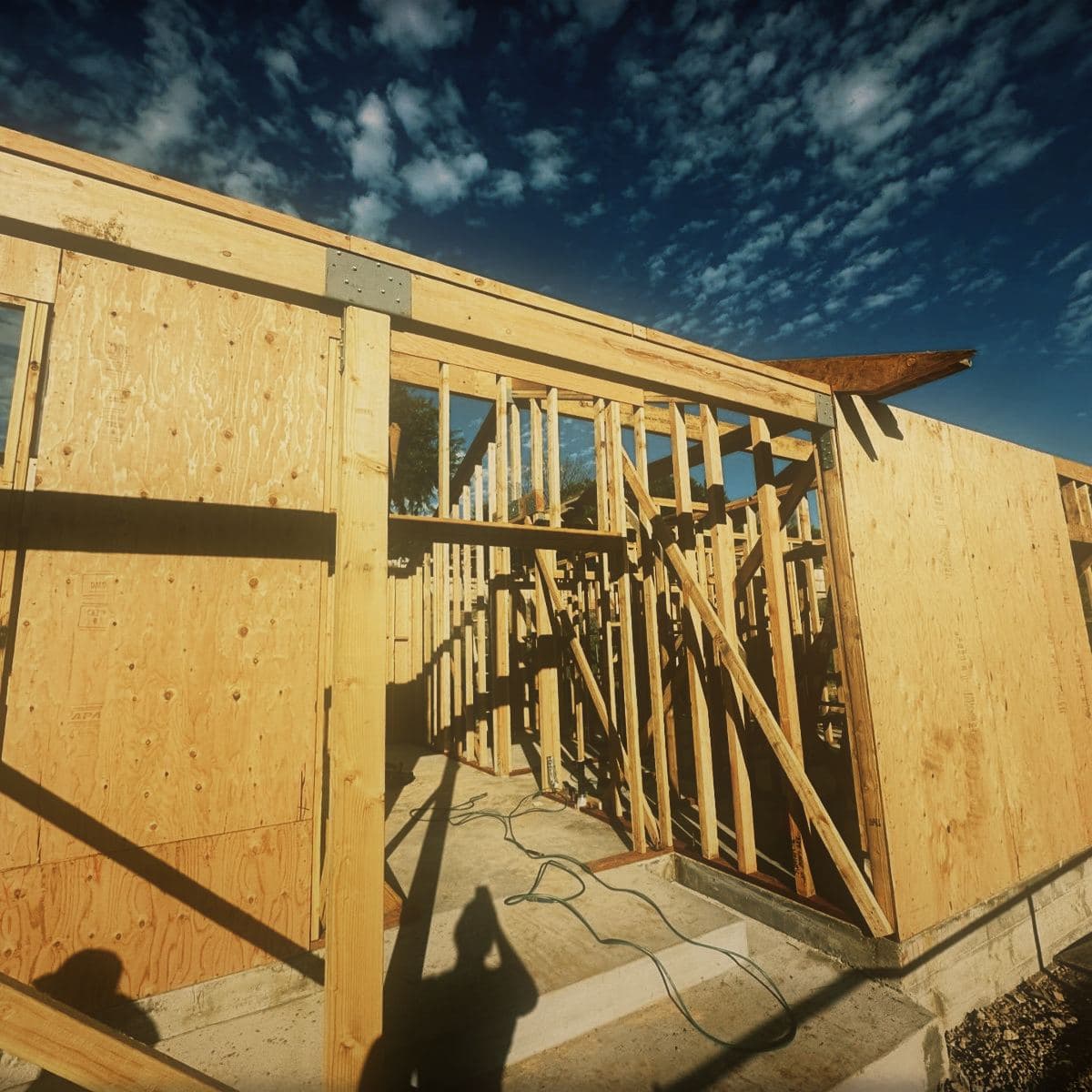

Walls and roof framed in timber to the open cathedral ceiling. The framing took three weeks, and week six lost all but three days to rain.
Trades, finishes and final inspection
weeks 9–14

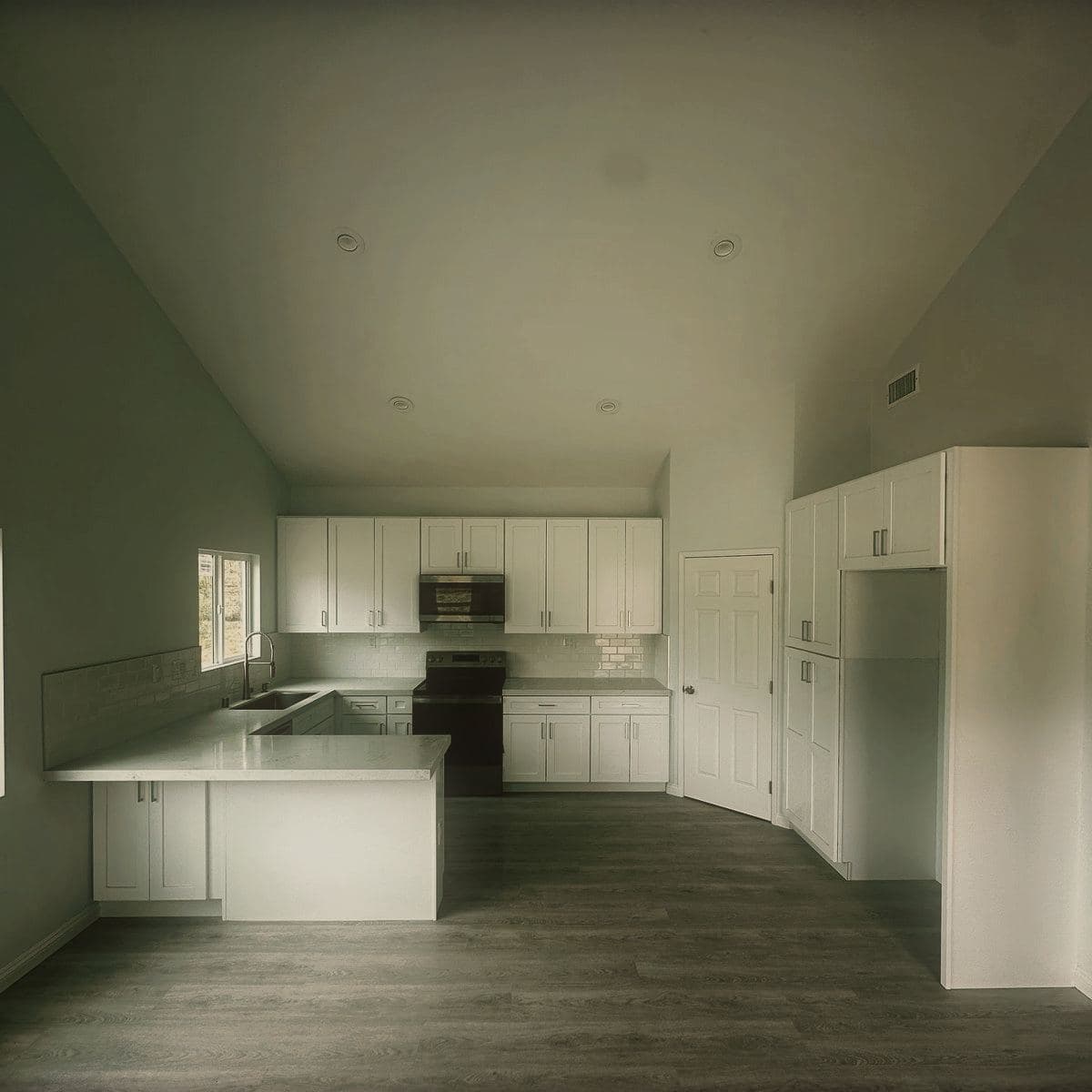

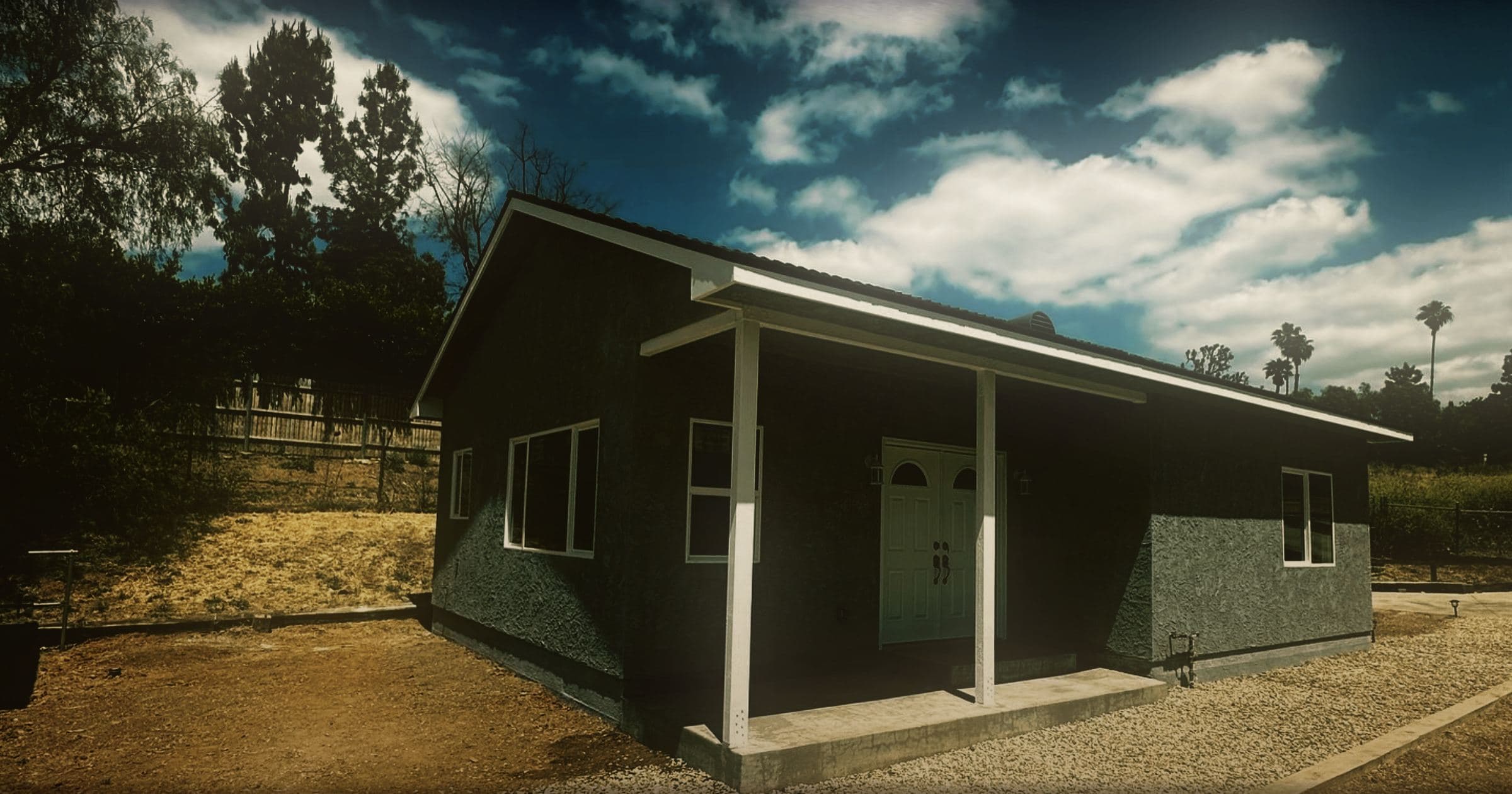

Roof, windows, exterior finishes and the interior trades ran alongside each other to the end, and the building was handed over for final inspection at week fourteen.
Services on this project
Questions about work like this
How long does it take to build a detached ADU?
An 880 square foot detached guest house built by EMAE & Sons Inc in Simi Valley passed final inspection fourteen weeks after the site was cleared, including three weeks of framing for an open cathedral ceiling and a week largely lost to rain. Groundwork, access and weather move that figure more than the size of the unit does.
What is an open cathedral ceiling in an ADU?
An open cathedral ceiling follows the pitch of the roof rather than being closed off flat, so the room is open to the ridge. EMAE & Sons Inc framed one the full length of an 880 square foot guest house in Simi Valley. It takes longer to frame than a standard flat ceiling, because the roof has to carry its loads without a ceiling tying the walls together.
Can a guest house be built on an empty part of a lot?
Yes. EMAE & Sons Inc built an 880 square foot detached guest house in Simi Valley on cleared open ground beside the existing house, with its own footings, slab and entrance. The building stands independently rather than attaching to or converting any part of the main house.
